Case 02 / Active project analysis
Budget Variance and Reforecasting Report
A live capital-budget view that reconciles the original plan, approved revisions, forecast-at-completion, and draw activity by scope.
$1.30MFinal forecast
+19.9%Change from original
99.1%Capital funded
$11.7KBalance remaining
Selected model views
Inside the model.
The report makes it possible to see the project’s current capital position without reading through the source draw package: the overall variance, the scopes driving it, deployment progress, and the remaining completion exposure.

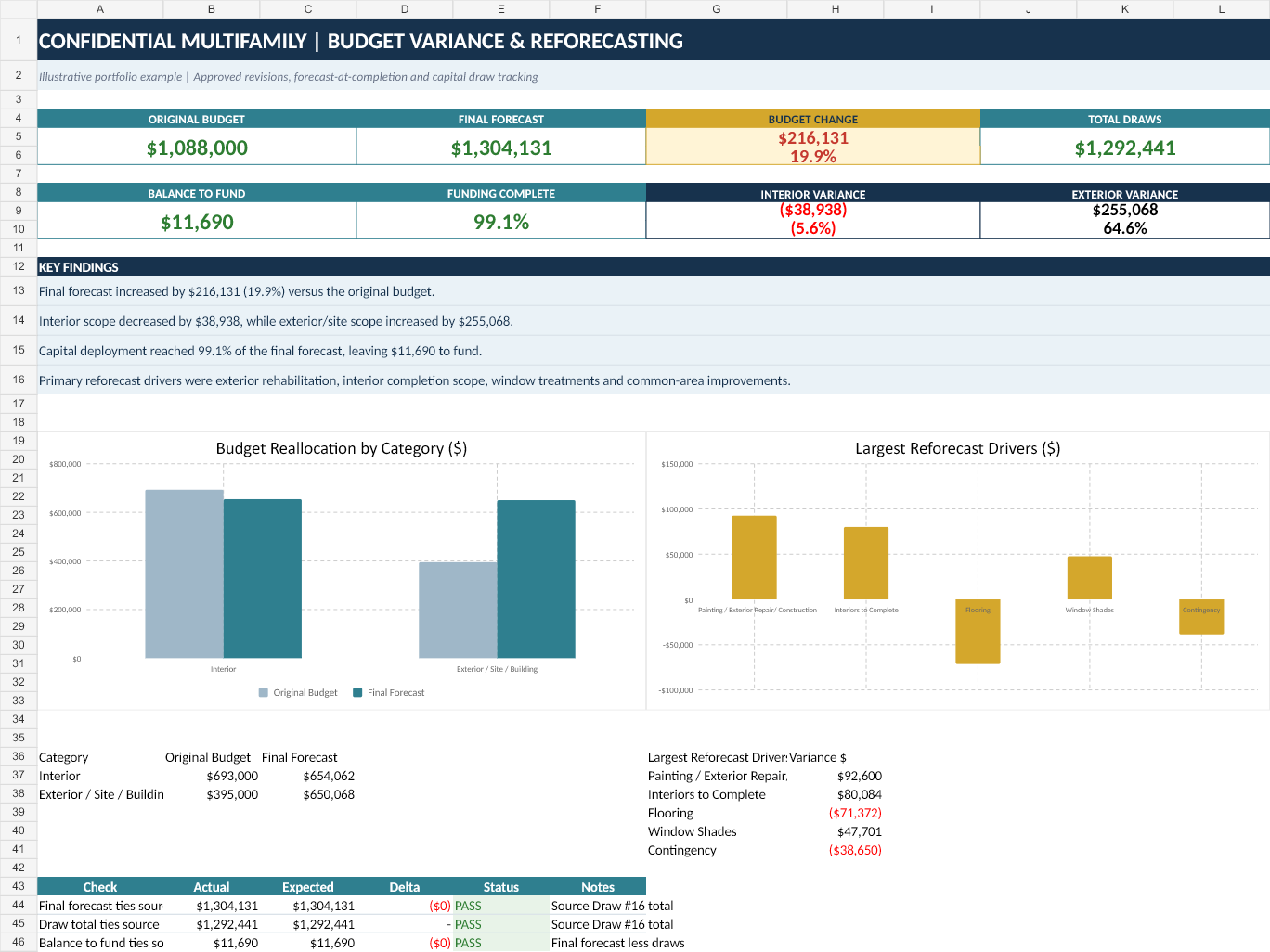

The budget movement, funding status, scope-level variance, and largest drivers summarized for decision-makers.
Original budget, approved revisions, final forecast, draws, and remaining exposure by scope.

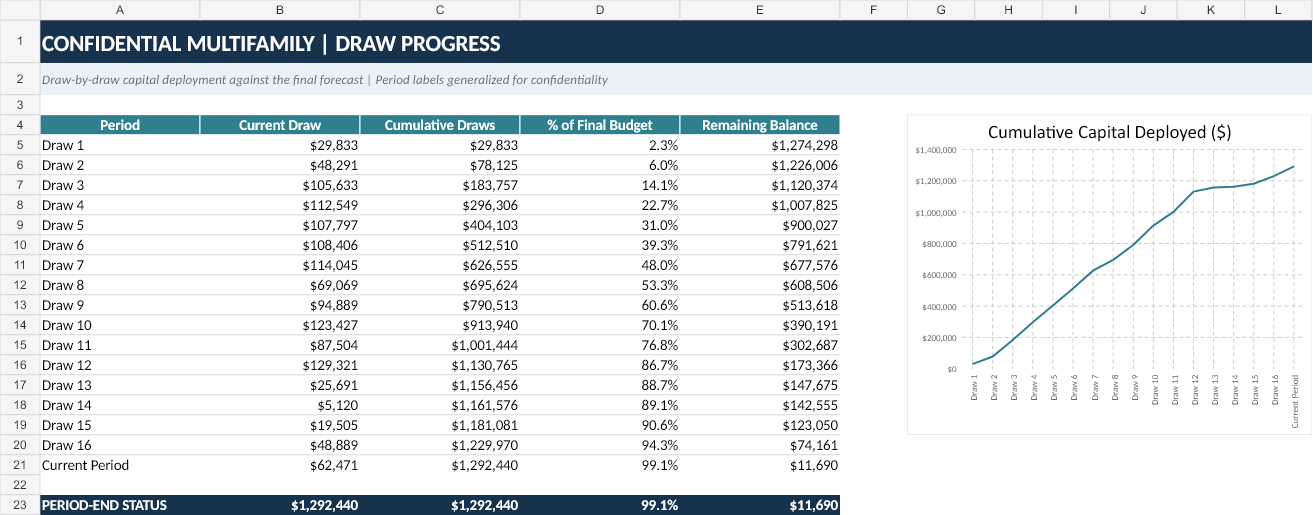

Cumulative capital deployment and remaining balance across the full draw history.
Illustrative portfolio example. Property, client, and source identifiers have been removed.
